Skip to main content Skip to footer
Menu

Te Mahere ā-Tau

Annual Plan 2025/26

Annual plans are the budgets and activity plans developed by councils for the year ahead. They include details on the main activities and financials to deliver this work, as well as user fees and charges.

Every three years, councils produce a Long Term Plan – a requirement under the Local Government Act. A Long Term Plan sets out the work we plan to do over the next 10 years and how that work will be funded.

For the two years between Long Term Plan reviews, councils prepare an Annual Plan. This sets out any changes or adjustments that have been made from the Long Term Plan (both to our annual goals and budgets).

The budgets in the Annual Plan will be used as the basis for setting rates (general and targeted). After every financial year, we produce an Annual Report to see how we delivered on those goals.

2025 AP Process

Annual Plan 2025/26 at a glance

With a changing economic climate and shifting direction from Central Government, Councillors recognise that there is a need to address rates affordability while still delivering on the essential services required by our communities.

Year two (2025/26) of the Long Term Plan 2024-34 budgeted for an increase of 8.2%* to general rates and a 6.3%* increase to targeted rates.

We want to reduce the budgeted rates increases, so we’ve made some changes to make this happen.

This means:

  • A general rates increase of 3%*
  • Reducing the total targeted rates to be collected by 2%*, noting that individual targeted rates are increasing and decreasing various amounts (more on this below)
  • $195 million operating expenditure (spending required to deliver our day-to-day services).
  • $41 million capital expenditure (the cost to purchase, improve and/or replace assets).

*Figures indicate nominal rates increase, which includes inflation.

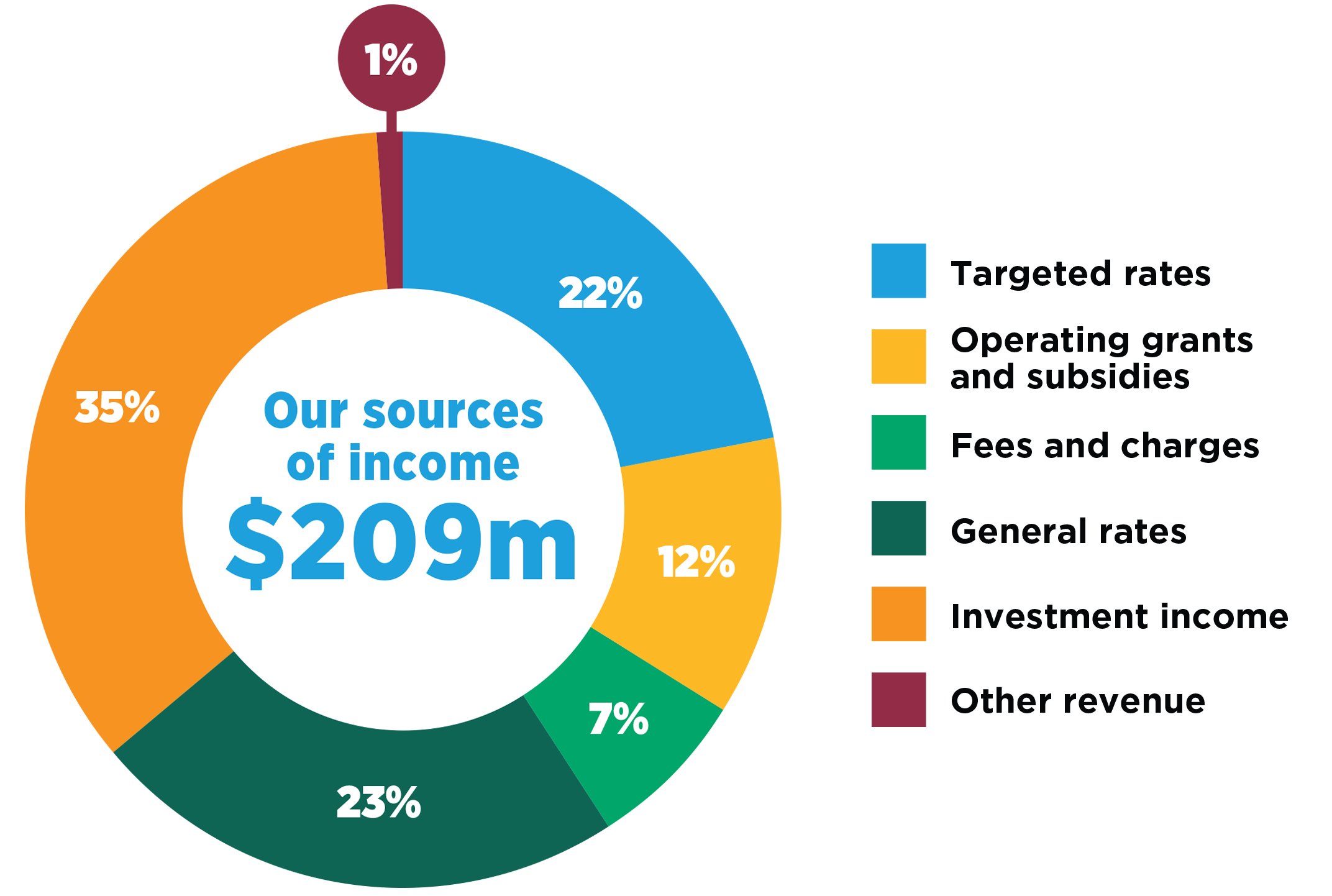

Where is the money coming from

The money collected through rates is expected to make up 48% of the funding for our operating expenditure.

Quayside Holdings Ltd, the Regional Council-owned investment company continues to make a significant contribution to Council revenue with $48 million expected to be contributed in the 2025/26 financial year. This revenue allows us to reduce the general rates that would otherwise be charged and ensures our community benefits from these investments.

source of income

Please refer to page 28 of the Annual Plan for full details of our sources of income.

Read the Annual Plan 2025/26

Key decisions | Ngā whakatau matua

Through a review, we identified $7.3 million in cost reductions that would mitigate rates increases while maintaining the continuity of essential services and ensured alignment with our strategic priorities.

Key changes include:

  • Public Transport: $3.87 million. The government announced a reduced level of funding subsidy from the NZ Transport Agency Waka Kotahi for public transport services, leading to a review and reduction of the public transport programme.

  • Freshwater: $370,000. Delays in planned work following changes to the Resource Management Act in October 2024. Regional Council will continue this work when a new National Policy Statement for Freshwater Management is released.

  • Flood Protection and Control: $280,000. Funding from central government has reduced interest and loan costs.

  • Rotorua Catchments: $800,000 moved to 2026/27 financial year. The funding for the Ohau Wall has been aligned to the timing of the work. This means total funding for the project ($1.6m) is spread over 2025/26 and 2026/27 financial years with $800,000 in each year.

  • Corporate: $627,000. Cost savings through better financial management, reducing interest costs and refining IT systems.

Caulerpa

He taiao ora
A healthy environment

  • Development of a regional biodiversity strategy.
  • Ongoing support for landowners, and catchment and care groups with expert advice and technical assistance.
  • Regional Pest Management Plan (RPMP) changes to increase the number of species covered by the plan.
Future proof

He hapori mata-hī awatea
Future ready communities

  • Delivery of critical flood resilience infrastructure (such as stopbanks and floodwalls), with support from Central Government ($20M co-funding for infrastructure projects in four of our five rivers and drainage schemes).
  • Deferring low-priority work into future years (such as Maketū pump station replacement).
  • New and ongoing partnerships to support communities with adapting to a changing climate.
Bayhopper bus

Ngā hapori e honoa ana, e whakamanatia ana hoki

Connected and enabled communities

  • Re-focusing the work programme to prioritise delivery of reliable, everyday public transport services.
  • Improving the public transport experience through the Baybus website.
  • Continuing the OnDemand rideshare service trial for the Tauranga South area into 2026.
  • Provide more than $1.9M in funding to eligible groups and organisations through our Community Funding programmes.

He whanaketanga mauri tū roa
Sustainable development

  • Continued investment through Quayside Holdings Ltd to support the growth and development in the region that benefits all ratepayers.
  • Support for and involvement in regional development initiatives that plan for the future of our region (such as SmartGrowth, Rotorua Future Development Strategy implementation and Eastern Bay of Plenty Spatial Plan).

Te Ara Poutama
The Pursuit of Excellence

  • Scope a strategy to implement Te Ara Poutama.
  • Implement the co-governance secretariat and He Ara Taituarā (Māori Initiatives) Fund. This fund supports initiatives that build tangata whenua capability and capacity to participate in Regional Council decision-making processes and operations.

Under the Local Government Act 2002, councils are required to consult on the Annual Plan if there are significant or material differences from the Long Term Plan (according to our Significance and Engagement Policy).

While some cost savings were identified, the draft Annual Plan remains consistent with the overall financial and strategic direction set out in the Long Term Plan 2024-34, so consultation was not required.

The budgets in the Annual Plan 2025/26 are then used as the basis for setting rates (general and targeted).

Rates invoices will go out to ratepayers around September, with payment due by 20 October 2025. Those who are paying by direct debt will see their payments adjusted prior to reflect the new budgets. You will receive a letter about this before any changes are made.

To find out the rates for your property for 2025/26, click here.

Read the Annual Plan 2025/26

Targeted Rates





LTP Year 1
(2024/25)
Budget
$000

LTP Year 2
(2025/26)
Budget
$000

LTP
 % Increase / Decrease

AP
2025/26
$000

AP
2025/26
% Increase / Decrease*

Rotorua Catchments

4,489

3,497

-22%

2,990

-33%

The main reason for this decrease is that the Rotorua Lakes is transitioning from being funded through a targeted rate to being funded by general rates (as per year two of the LTP). This was consulted on and decided through the Long Term Plan 2024-34 process.

We are also deferring $800,000 allocated for the Ohau Wall project in year two of the LTP into next financial year (noting that there is budget to cover any investigatory or maintenance works required during 2025/26).

Targeted Rates





LTP Year 1
(2024/25)
Budget
$000

LTP Year 2
(2025/26)
Budget
$000

LTP
 % Increase / Decrease

AP
2025/26
$000

AP
2025/26
% Increase / Decrease*

Rivers & Drainage Schemes 16,688 17,756 6% 17,482 5% (total)
Kaituna Catchment Rivers Scheme 3,846 4,093 6% 4,051 5%
Rangitāiki-Tarawera Rivers Scheme 5,738 6,143 7% 6,134 7%
Whakatane-Tauranga Rivers Scheme 3,191  3,604 13% 3,180 0%
Waioweka-Otara Rivers Scheme 1,504 1,704 13% 1,606 7%
Rangitāiki Drainage Scheme 1,613 1,715 6% 1,556 -4%
Minor Rivers and Drainage Schemes  796 497 -38% 956 20%

Overall, there is a 5% total targeted rates increase for the rivers and drainage schemes.

Across the rivers and drainage schemes, there are common themes affecting the amount targeted rates are increasing or decreasing. These include higher depreciation of assets due to asset revaluations and reduction in insurance premiums for flood protection assets.

The main reason for decreases is that Regional Council was the recipient of $20m in central government funding for new infrastructure projects. This funding has been allocated to stopbanks and pump station upgrades in the Kaituna ($8,420,000), Stage 2 and 3 of Project Future Proof to replace the stopbanks and floodwalls in Whakatāne ($10,690,000), and stopbank upgrades in and around Ōpōtiki ($1,200,000).
These capital projects are funded through borrowings and these capital grants are reducing the loan servicing cost that is driving the saving.

Minor Rivers and Drainage Schemes increase

The increase to the minor river and drainage schemes reflects actual costs incurred for the schemes, which differ from what was budgeted in year two of the LTP.

In the Rangitāiki Plains, there are 34 communal pump schemes where Regional Council manages, but does not own, the assets within these schemes.

These schemes operate on a user pays system, where 100% of the targeted rates for these schemes go towards the management and maintenance of assets (mainly pump stations) that specifically benefit these landowners.

These targeted rates are separate from the targeted rates for the major rivers and drainage schemes.
These communal pump schemes have their own budgets, where we forecast what the costs may be for the upcoming financial year. At the end of the financial year, we then invoice the landowners in these schemes the actual costs incurred for managing and maintaining their assets.

Targeted Rates





LTP Year 1
(2024/25)
Budget
$000

LTP Year 2
(2025/26)
Budget
$000

LTP
 % Increase / Decrease

AP
2025/26
$000

AP
2025/26
% Increase / Decrease*

Transport Service Delivery  21,119 24,009 14% 20,719 -2% (total)
Tauranga City 16,309 19,217 18% 16,276 0%
Western Bay District 909 2,996 15% 902 -1%
Rotorua Urban 3,265 1,043 -8% 2,863 -12%
Whakatāne District 636 752 18% 678 7%

Overall, there is a 2% decrease in all transport service delivery targeted rates.

The main driver for this is a reprioritisation of projects, following a reduction in funding subsidy from the NZ Transport Agency for public transport services. These include Pāpāmoa Park and Ride Trial, tertiary commuter services, bus de-carbonisation initiatives and travel demand management.

Further to this, there was a reduction of $2.3m into the Urban Form and Transport Initiative (UFTI) for Tauranga city (due to no upcoming projects planned for 2025/26 in the UFTI programme), and the network refresh in Rotorua has been deferred.

Targeted Rates





LTP Year 1
(2024/25)
Budget
$000

LTP Year 2
(2025/26)
Budget
$000

LTP
 % Increase / Decrease

AP
2025/26
$000

AP
2025/26
% Increase / Decrease*

Regional Safety and Rescue Services 695 722 4% 716 3%

Reflects a 1% reduction from what was budgeted in Year 2 of LTP. This was due to efficiencies made.

Targeted Rates

LTP Year 1
(2024/25)
Budget
$000

LTP Year 2
(2025/26)
Budget
$000

LTP
 % Increase / Decrease

AP
2025/26
$000

AP
2025/26
% Increase / Decrease*

Emergency Management 5,017 5,139 2% 5,332 6%

The main reason for this increase is the ‘vacancy factor’ assumption.  This refers to the percentage of open, unfilled positions within an organisation relative to the total number of positions.

Total combined targeted rates increase / decrease: 48,008 51,123 6% 47,239 -2%

*Figures are nominal rates increase, meaning it includes inflation.
