Explore the Kopeopeo Canal
Find results of samples collected along the Canal.
Get notified by email when we update this project.
Send us any feedback, images, videos, news or other content about this project.
PROJECT CREATED
SHARE THIS PROJECT

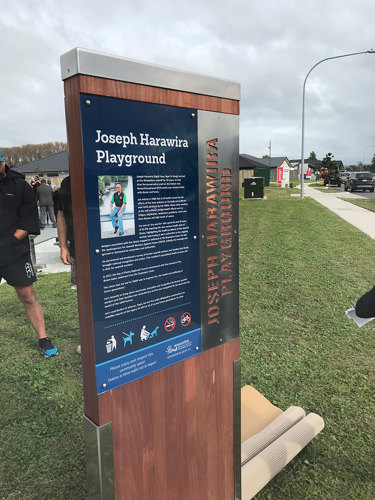

The newly named Joseph Harawira Reserve within the Shaw Road subdivision was officially opened on Saturday 8 May 2021.
The newly named Joseph Harawira Reserve within the Shaw Road subdivision was officially opened on Saturday 8 May 2021.
Joseph Harawira and Sawmill Workers Against Poisons (SWAP) were instrumental in kick-starting this large-scale project and their legacy is the removal of dioxins Kopeopeo Canal for future generations.
Mayor Judy Turner, Joe Harawira, Barney and Prudence Gray, representatives from the local and regional councils joined whānau and friends, supporters and members of the public at the event.

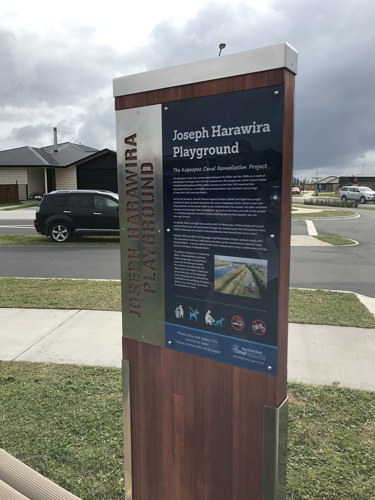

You can read a little about the Kopeopeo Canal Remediation Project on the new signs installed at the playground.
The Project continues in a monitoring capacity – the containment sites are carefully monitored and work also continues to monitor progress of bioremediation inside the geotubes at the two sites (although this will be a long natural process over at least ten years or so).

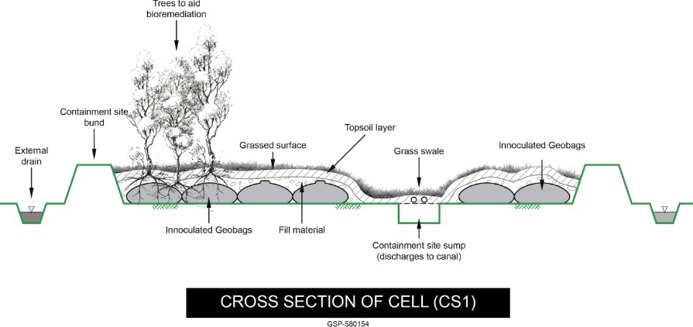

Capping of both CS3 and CS1 has been completed and both sites are looking very good.
There has been good progress over the summer months. Capping of both CS3 and CS1 has been completed and both sites are looking very good.
New signs have been put up indicating that the canal is now remediated with ongoing monitoring and recreational use is encouraged (although it is worth noting that fishing and eeling are still prohibited until tissue results come back clear).
Some Giant Willow Aphids have been found in some of the willows at CS1 and these are being treated with biocontrol using tiny predator wasps released by Scion in coordination with the bioremediation science team. The biocontrol has been approved by the EPA and is supported by the Ministry for Primary Industries (MPI) and other agencies.
We expect to be able to open CS3 to public vehicle access shortly and we are planning for a completion celebration in March so please watch this space for more information coming soon.
Our project has scooped the Australasian Land and Ground Water Association (ALGA) project excellence award for Best Regional Remedial Project at last month’s awards ceremony. Read more about it here.
Thanks to everyone who has been on this journey and celebrated two outstanding milestones with us last week.
Thanks to everyone who has been on this journey and celebrated two outstanding milestones with us last week.
We have completed dredging of the project area and held our final Community Liaison Group meeting.
13 July marks the end of the Kopeopeo Canal dredging project when the validation samples from the final section of the canal returned results below the remediation target.
A significant milestone was reached on 13 July when the validation samples from the final section of the Canal returned results below the remediation target. This marks the end of the dredging component of the project.
At present the dredge equipment and water treatment plant is all being cleaned down, prior to decommissioning and removal from Containment Site 3 (CS3). Once this process has been completed the bioremediation phase will be initiated at CS3.
The flood control structure at the western end near SH30 is being modified over the next 1-2 weeks to allow flow to resume to the east. The eastern flood control structure near the Orini Stream confluence will also be removed in the coming weeks.
Capping material and topsoil has been placed over some of the geobags at Containment Site 1 (CS1). The topsoil has been grass-seeded and the trees have been planted into the bags that are now covered. Cover material will continue to be place over the remainder of the bags throughout this year.
We have started planning for our last CLG meeting on 20 August so please make sure it is in your diary.
We achieved a significant milestone on Saturday as the dredge reached the end of the project area.
We achieved a significant milestone on Saturday as the dredge reached the end of the project area.
Great work and a huge thanks to the dredging team and all their support crew. From here, the dredge will go over a few spots and then park up until validation results are received. Once we are sure that all areas are validated to our environmental requirements, demobilisation will start.
In other news, we have started capping CS1 with topsoil and some areas will be ready for tree planting as soon as July (most of the bags have already been inoculated with bioremediation materials).
The dramatic night lift of a barge, excavator and other machinery over Keepa Road Bridge in Whakatāne marked a smooth transition into the final section of the Kopeopeo Canal for the remediation project.
The dramatic night lift of a barge, excavator and other machinery over Keepa Road Bridge in Whakatāne marked a smooth transition into the final section of the Kopeopeo Canal for the remediation project.
The Bay of Plenty Regional Council, with co-funding from the Ministry for the Environment, is working with the community to clean up dioxin-contaminated sediment in the Kopeopeo Canal. The canal was contaminated between the 1950s and late 1980s as a result of stormwater discharges from a former sawmill, which treated timber using Pentachlorophenol (PCP).
Above: Crane lift over Keepa Road (click on each image for high res version).
The Kopeopeo Canal Remediation Project is removing sediment from the canal using a barge-mounted cutter-suction dredge. Sediment is transferred along a pipeline to Geotubes® inside containment sites.
As the barge moves along the canal it needs to be lifted over bridges and pipelines enroute. This lift is the sixth and final of the bridge lifts along the project length.
Deputy Project Manager, Ken Tarboton, said that the process went very smoothly and according to plan.
“All of the other lifts have been in daylight hours, but this was at night because the contractor wanted to minimise any potential traffic-related effects.
“There was a lot of planning and preparation to ensure safety of all the workers on site and to make sure that there were contingencies and back-up plans in place. There is a lot of equipment to move in the right order – first removing all the materials from the barge and setting them aside so we can move the barge itself to the other side of the bridge. Then we needed to put it all back together again on the other side. Full credit to the contractor crane crew and site manager, Des McCleary from EnviroWaste Services Limited for such a smooth lift,” Mr Tarboton said.
Dredging will continue along the final section of the canal towards the confluence with the Orini Stream. Four kilometres of the total 5.1km has been dredged to date, marking approximately 80% completion.
Dredging is expected to be completed by the middle of the year, but works will continue on the Keepa Road containment site to cover and start bioremediation of the contained material. During that time, access through the site along the stopbank will remain restricted.
It has been a busy few months on the Kopeopeo Canal Remediation Project and this newsletter provides a short update on dredging progress to date, moving to the new containment site, recent community meetings and how to find out more.
It has been a busy few months on the Kopeopeo Canal Remediation Project and this newsletter provides a short update on dredging progress to date, moving to the new containment site, recent community meetings and how to find out more.
In this update:
Following a pause in dredging over the December and January period, dredging is back underway on lower section of the Project area, down towards the wetlands. Work paused to allow plant and machinery to move to the second containment site off Keepa Road. This marks a significant milestone - more than half of the 5km length of the canal to be cleaned by the Project had now been completed.
The contractor, EnviroWaste Services Limited, has started using an improved dredge head and a few tweaks have been needed at the start of the year as we get up to speed, but dredging in the Canal section from Whakatāne’s wastewater ponds towards Keepa Rd is now well underway.
Dredging has been slower than we anticipated as our focus continues to be safe removal and transfer of the contaminated sediment into sealed geotube bags at the containment sites. We now expect dredging to continue until around the middle of the year. Following that, there will be considerable follow up work to cover the geotube bags at the containment sites and ongoing civil works (cover material, tree planting, adding inoculated material and reinstatement) to get bioremediation going. For that reason we expect that the Keepa Road containment site will continue to allow pedestrian-access only until early next year. We will continue to keep the community informed and up to date on progress.
The February CLG meeting was a busy one and the meeting minutes are now available on the website. As usual, these minutes are considered draft until they are confirmed at the next Meeting.
For those who missed the meeting, the presentations are also available on the website and there are some useful graphics and diagrams to show progress. There was some interesting discussion at the meeting about the dioxin levels in each of the geobags at Containment Site 1 and validation test results.
A ‘Tech Talk’ is tentatively planned for at the next CLG on Tuesday 14 May to help better understand the differences between validation testing, sampling and chemical validation. We look forward to seeing a good turnout for this.
In February, dredging re-started and the sediment is now being transferred to Containment Site 3, located on the riverbank near Keepa Road.
The Keepa Road carpark is a popular public-access spot, particularly for dog walkers and cyclists. With the additional truck movements and site activity in the area, we are asking that people are extra cautious around the Keepa Road bridge site entrance and keep a careful lookout for vehicles.
We have completed a tidy-up of the Pedestrian access alongside Containment Site 3 and it continues to be a well-used path.
There has been some public discussion about pedestrian access alongside the Keepa Road Containment Site and at this stage pedestrian access only is likely to continue through until at least early next year.
We understand that it is frustrating for some whitebaiters but appreciate the community support through this process. The end result of the short-term frustration will be a healthier (and fishable) Canal for future generations.
Recent non-human mamal bones and Karakia before works recommenced
The Project employs a cultural monitor to provide advice on cultural matters and to ensure that any cultural finds are managed in accordance with the Ngāti Awa protocol for dealing with koiwi or taonga.
We follow a strict process for dealing with any finds in the sediment, although it is worth noting that most finds are old coins and animal bones. Our consultant archaeologist is informed and strict procedure followed. If you would like to know more about this interesting aspect of the Project, come along to the next CLG meeting and have a chat with our Cultural Monitor, Eula Toko.
Given the proximity to a number of residences and businesses, we are keeping careful track of noise associated with the works including the boost pump on the Canal bank near Kope Canal Road which will operate for a relatively short time.
We have also had a few of complaints about dust coming from Kope Canal Road opposite Gateway drive. The mobile dust monitor has been placed close to the boost pump and dust levels are being continuously monitored to ensure they stay below compliance requirements (to date they have been). Whakatāne District Council staff accessing the oxidation ponds and project contractors have been asked to keep speeds down on that road to reduce dust as much as possible.
And finally, a recent compliance check means that Containment Site 3 is fully compliant and there were some useful suggestions on dealing with the oversize material.
It has also been a busy year for the Chair of the Community Liaison Group, John Pullar.
You may remember John was a TVNZ Good Sort last year. He also received a Kiwibank Local Hero medal for his outstanding contribution to our community. He was a finalist in the Herald’s People’s Choice awards for New Zealander of the Year and received the Queens Service Medal in the New Year’s Honours List. Well done John! We are very fortunate to have you as the Chair of our community group and we appreciate your hard work for the community. Congratulations.

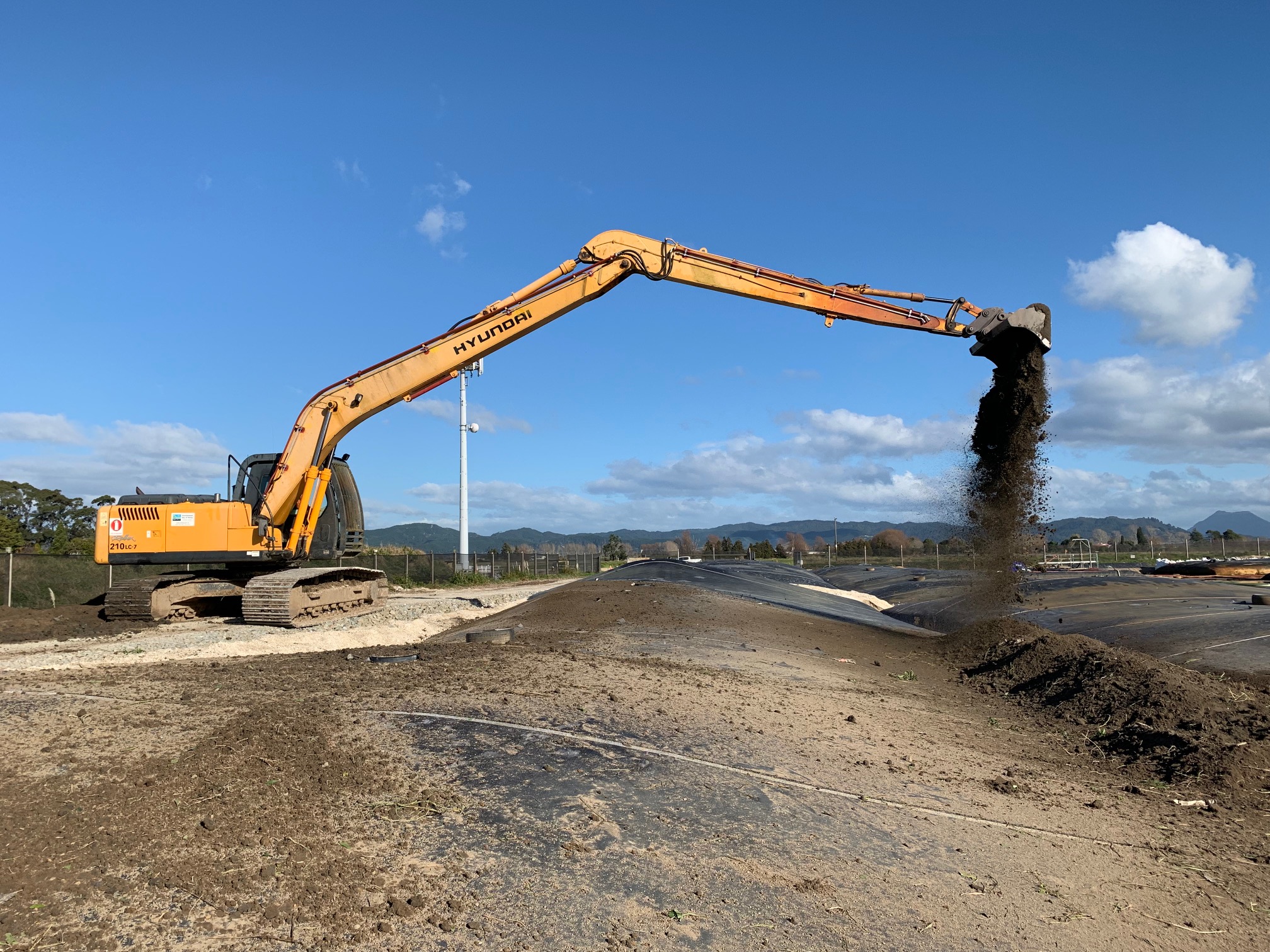

Dredging is progressing well with more than 260m dredged since February and the sediment is steadily filling four of the geotubes on containment site three. One hundred metres of that section has also been validated.
Dredging is progressing well with more than 260m dredged since February and the sediment is steadily filling four of the geotubes on containment site three. One hundred metres of that section has also been validated.
There has been some discussion about the discharge from CS3 into the Kopeopeo Canal. The pipe can be seen from Keepa Rd and it has raised some questions for passers-by. We will be putting up some signs in the coming weeks letting people know that it is a monitored and compliant discharge of clean water that comes out of the geotube bags. The turbidity of this water is continuously monitored on release to the Canal.

Pictured above: Mobile dust monitoring at Gateway industrial area.
There has also been a lot of oversized material and we are working on improvements to manage it better including changes in the skip bins and processes.
We have also had a number of complaints about the dust – primarily from the Kope Canal Road opposite Gateway drive. The mobile dust monitor has been placed close to the Boost pump and dust levels are being continuously monitored to ensure they stay below compliance requirements (to date they have been). We are aware of the issue, and have asked Whakatāne District Council staff accessing the oxidation ponds and our own contractors to keep speeds down on that road to reduce dust as much as possible.
And finally, a recent compliance check means that Containment Site 3 is fully compliant and there were some useful suggestions on dealing with the oversize material.
Another significant milestone has been achieved for the Kopeopeo Canal Remediation Project as dredging of the Canal resumes and water treatment works move to the second containment site at the Whakatāne River end of the Kopeopeo Canal.
Another significant milestone has been achieved for the Kopeopeo Canal Remediation Project as dredging of the Canal resumes and water treatment works move to the second containment site at the Whakatāne River end of the Kopeopeo Canal.
Deputy Project Manager, Ken Tarboton, said that moving to the new containment site off Keepa Road represented the progress made by the Project to date. More than half of the 5km length of the canal to be cleaned by the Project had now been completed.
“Last week, dredging got underway again pumping the dredged sediments to the second site, CS3 [Containment Site 3]. The contractor, EnviroWaste Services Limited, has commissioned an improved dredge head, and is currently making fine adjustments during the next week while they ramp up to full speed.
“It is a good time to look up and appreciate what has been achieved to date. It can be easy to get caught up in the day-to-day nuts and bolts of such a big project so the visibility of the move to the new site is a good reason to acknowledge the 2.8km of Canal that has had the dioxin-contaminated sediment removed and the Canal will be healthier and better for the next generation,” Mr Tarboton said.
In stages, the Project will remove and safely store up to 40,000m3 of sediment from the Canal using the cutter-suction dredge and Geotube® containment methodology. Following dredging the contained sediment will be treated using bioremediation. The Canal was contaminated between the 1950s and late 1980s as a result of stormwater discharges from a former sawmill, which treated timber using Pentachlorophenol (PCP).
Pedestrian and bicycle-only access to the Whakatāne River stopbank will remain for the health and safety of the public throughout the duration of the Project.
“This is a working operation dealing with contaminated material and we ask that people walking dogs or accessing the river to fish and so on stick to the marked access paths for their own safety,” Mr Tarboton said.
Access through the site will remain restricted for the duration of the dredging phase of the project and during some of the site works and bioremediation towards the end of the year.
Contractors have been asked to be particularly aware of pedestrians and cyclists at the site entrance off Keepa Rd, and the public is asked to be cautious around the Keepa Road bridge as there is increased contractor traffic to the site.
The community continues to be involved in the Project through the Community Liaison Group and activities such as last year’s well-attended public open day. Businesses near the new work site recently received a letter providing an update and letting them know site operating hours and contact details in case of any issues. An independent monitor also keeps a close watch over the Project, reporting back to the community with regular updates and feedback.
“Dredging has been slower than anticipated as the focus has continued to be safe removal and transfer of the contaminated material to the containment sites. We expect dredging to continue until around the middle of the year. If people have any questions for the team they are welcome to get in touch, or come along to the next CLG [Community Liaison Group] meeting on Tuesday 26 February which is open to the public,” Mr Tarboton said.
Thanks to everyone who came out to the containment site on the corner of Kope Drain Road and SH30 on Saturday. We had an excellent turnout with more than 60 people being shown around the site.
Thanks to everyone who came out to the containment site on the corner of Kope Drain Road and SH30 on Saturday. We had an excellent turnout with more than 60 people being shown around the site. I was thrilled with the engagement and in-depth questions asked of the project manager and site manager. It was genuinely difficult to interrupt the conversations to start the next tour group and that was how it should be. Thanks everyone!
Watch a clip of John Pullar, Chairperson of the Kopeopeo Canal Community Liaison Group, tackle getting a community back on track after devastating floods.
While it is not directly Kopeopeo related, we were still chuffed to see our Community Liaison Group (CLG) Chairperson, John Pullar, on the news as our local 'Good Sort' for his work in the post-April flood re-build. Awesome work John!
We're very excited to announce that we will be holding the community open day for the Kopeopeo Canal Remediation Project on Saturday 16 June 2018.
We're very excited to announce that we will be holding the community open day for the Kopeopeo Canal Remediation Project on Saturday 16 June. We look forward to seeing you at 1 Kope Drain Road where brief tours will be given from 10am until 12.30pm. For more information contact Kopeopeo@boprc.govt.nzor call 0800 884 880.
The Community Liaison Group meeting held on Tuesday 29 May 2018 was an eventful one so thank you to all those who came along and made it so memorable.
The Community Liaison Group meeting held on Tuesday 29 May 2018 was an eventful one so thank you to all those who came along and made it so memorable.
Those present were enlightened by Karam de Lacey of Control Tech about the advanced technology being used in the field to monitor turbidity and water levels on the project for routine monitoring and flood situations. And to top it all off attendees were regaled with the chance to view and hold a moa bone discovered in Coastlands by Guy Barlass. Now that's something you don't see every day.
We are pleased to confirm that Karam de Lacey of Control Tech will present a Tech Talk at the next CLG meeting on 29 May 2018.
We are pleased to confirm that Karam de Lacey of Control Tech will present a Tech Talk at the next CLG meeting on 29 May 2018. Karam will talk through the various environmental monitoring tools used on the Kopeopeo Canal Remediation Project to give the Project Team real-time data to guide their decision-making on flood management. Members of the community are warmly invited to attend the meeting to find out about this fascinating aspect of the Project.
For seating and catering purposes, please email kopeopeo@boprc.govt.nz to register your interest in attending. The agenda will be published on the CLG page one week prior to the meeting. The minutes from the last meeting held in late-April are now available on this page.
