We're repairing the flood damage to our rivers and drains to protect people, property and livelihoods.

Two extreme weather events in early April 2017 brought prolonged torrential rain to the Bay of Plenty. The resulting record high river levels and extensive flooding caused significant damage to river and drainage networks and assets across the region, from the Kaituna River in the west through to the Waioeka and Otara Rivers in the east.

A total of 520 sites have been identified in the repair programme with a repair estimate in excess of $45 million. The majority of damage is in the Eastern Bay of Plenty with over half the work associated with the Rangitāiki-Tarawera Rivers Scheme.

Each damaged site has been prioritised based on the risk of the damage becoming worse, the consequence of that occurring, any impact to community assets, and the practical ability to complete the work required. High priority works are programmed to be completed by December 2019.

The entire repair project is expected to take four years, with completion programmed for 30 June 2021.

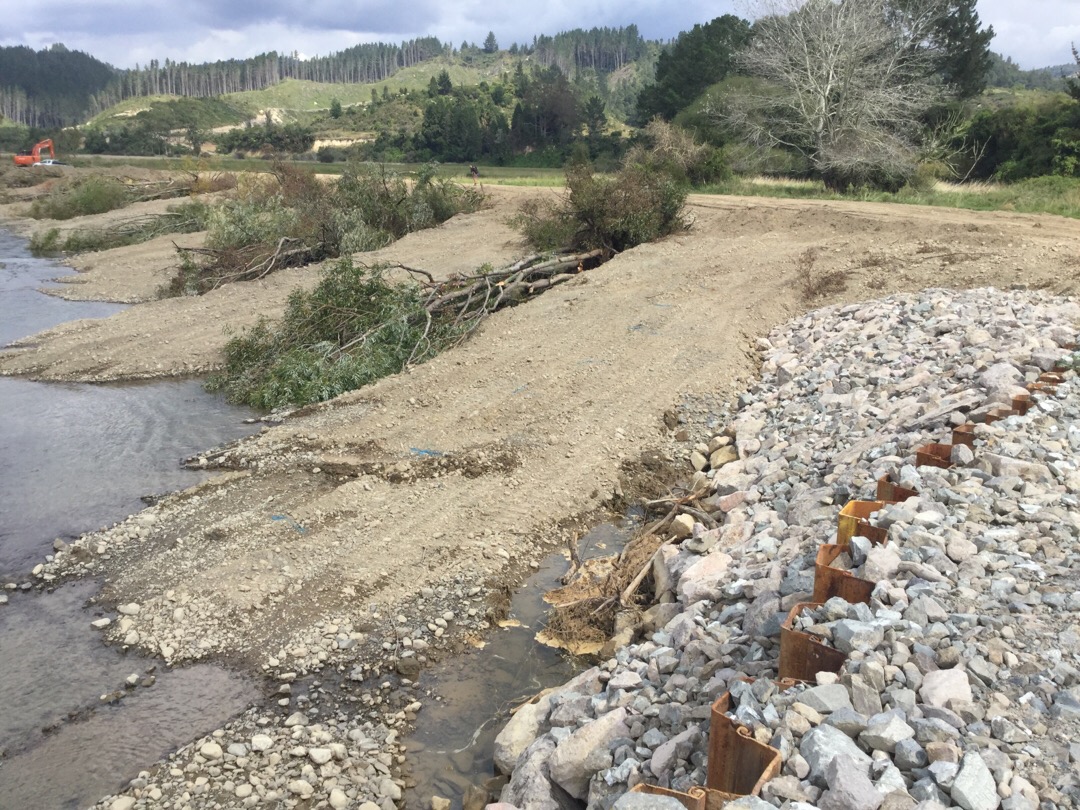

trench willow Ruatoki

Get notified by email when we update this project.

Send us any feedback, images, videos, news or other content about this project.

SHARE THIS PROJECT

Project Updates

4 months ago

Flood repair update – latest poster for July 2021

We’re continuing to make progress on our flood repair project – as at 30 June 2021, 500 sites were completed.

Flood repair update – latest poster for July 2021

We’re continuing to make progress on our flood repair project – as at 30 June 2021, 500 sites were completed.

Flood repair update – latest poster for July 2021
7 months ago

Flood repair update – latest poster for April 2021

We’re continuing to make progress on our flood repair project – as at 31 March 2021, 483 sites were completed.

Flood repair update – latest poster for April 2021

We’re continuing to make progress on our flood repair project – as at 31 March 2021, 483 sites were completed.

Flood repair project poster - April 2021
7 months ago

Waioeka-Otara 2017 Flood repairs complete

Toi Moana Bay of Plenty Regional Council has finished repairs on the 61 sites that were damaged on the Waioeka-Otara rivers during the 2017 flood and storm event.

9 months ago

Flood repair update – latest poster for December 2020

We’re continuing to make progress on our flood repair project – as at 31 December 2020, 439 sites were completed.

Flood repair update – latest poster for December 2020

We’re continuing to make progress on our flood repair project – as at 31 December 2020, 520 sites were completed.

Flood repair project poster - December 2020
12 months ago

Flood repairs beside Whakatane River Reserve

Repair is set to start on one of the few remaining sites on the Whakatāne River damaged after the 2017 flood and storm event. The work will see the replacement and repair of the rock armouring along the Whakatāne River downstream of the Landing Road Bridge.

The work will mean use of the Warren Cole Cycle/Walkway will be controlled at times. To ensure public safety, parts of the river reserve, the cycle/walkway and the Eivers Road Reserve will be restricted for public use while works are being carried out.  Users are asked to pay attention to signage.

Local residents are asked to avoid the area at the very end of Eivers Road and particularly keep an eye out for truck and machinery movement around the reserve, cycle/walkway and Eivers Road.

Flood repairs beside Whakatane River Reserve

Repair is set to start on one of the few remaining sites on the Whakatāne River damaged after the 2017 flood and storm event. The work will see the replacement and repair of the rock armouring along the Whakatāne River downstream of the Landing Road Bridge.

The work will mean use of the Warren Cole Cycle/Walkway will be controlled at times. To ensure public safety, parts of the river reserve, the cycle/walkway and the Eivers Road Reserve will be restricted for public use while works are being carried out.  Users are asked to pay attention to signage.

Local residents are asked to avoid the area at the very end of Eivers Road and particularly keep an eye out for truck and machinery movement around the reserve, cycle/walkway and Eivers Road.

Bay of Plenty Regional Council’s Project Manager Paula Chapman said the works are programmed to start next week on site access to be followed by rock placement. She expects the the job will be completed by Christmas assuming the weather and ground conditions remain favourable.

“The rock armouring on the town side of the river was damaged during the floods in 2017. This medium priority repair is important to support the town’s flood defence stopbanks.”

“We just ask that people out and about in the area take extra care for the next few weeks and the contractors will be extra vigilant as well. If residents have any questions or concerns, please call Bay of Plenty Regional Council on 0800 884 880.”

On completion, reinstatement works will tidy the area including any paving damaged and it will be returned to normal access and use.

The 2017 storm and flood event caused damage to 520 sites across the region’s river and drainage networks leading to a repair budget of $45m. The majority of highest priority works have been completed. The balance of high priority sites, and the remaining approx. 100 sites  assessed as lower priority, are scheduled for repair by 30 June 2022.

ENDS

For further media information, please contact Kay Boreham, Communications Partner, Bay of Plenty Regional Council via email Kay.Boreham@boprc.govt.nz

about 2 years ago

Flood repair update – latest poster for September 2020

We’re continuing to make progress on our flood repair project – as at 30 September 422 sites were completed.

Flood repair update – latest poster for September 2020

We’re continuing to make progress on our flood repair project – as at 30 September, 422 sites were completed.

Flood repair project poster - September 2020
about 2 years ago

Flood repair update – latest poster for June 2020

We’re continuing to make progress on our flood repair project – as at 30 June 373 sites were completed.

Flood repair update – latest poster for June 2020

We’re continuing to make progress on our flood repair project – as at 30 June, 373 sites were completed.

See the full poster.

Flood repair project poster - June 2020
about 2 years ago

Flood repair update – latest poster for March 2020

We’re continuing to make progress on our flood repair project – at 31 March 333 sites were completed. Find out more about progress on our website.

Flood repair update – latest poster for March 2020

We’re continuing to make progress on our flood repair project – at 31 March 333 sites were completed. Find out more about progress on our website.

Flood repair project poster - March 2020
about 2 years ago

With summer weather well and truly here, flood repair works have resumed, and Regional Council is working on seven sites in the area from Tanekaha Street to the Go Cart club.

Summer works begin

With summer weather well and truly here, flood repair works have resumed, and Regional Council is working on seven sites in the area from Tanekaha Street to the Go Cart club.

During winter of 2019, in preparation for the start of summer works, rock was carted to stockpiles near the repair sites in anticipation of settled weather and drier ground conditions.

Tony Dunlop, Flood Restoration Project Engineer says earlier prep work means our teams are already underway at the Domain Reserve (RT107) with rock lining to river banks, and the remaining six sites will follow.

“The use of rock lining is to repair bank erosion and at the moment we are concentrating on the area between Tanekaha and the Go cart club. These seven sites run along the river on both the left and right bank”.

Currently the flood restoration project has moved beyond the half-way point, with 57% of the total programme complete and over 64% of high priority sites now repaired.

Check out the Flood Repair Infographic for additional information and progress tracking.

Flood repairs summer site 2020
about 3 years ago

Flood repair update – latest poster for Oct 2019

Progress to date – repairs on 266 sites have been completed.

Flood repair work on track – see latest poster

Progress to date – repairs on 266 sites have been completed.

Check out the Flood Repair Poster for additional information and progress tracking to 30 September 2019.

Check out the Flood Repair Poster for additional information and progress tracking to 30 June 2019.

Flood repair project poster
about 3 years ago

Flood repair work on track – updated information poster available

Progress to date – repairs on 249 sites have been completed. College Road stopbank realignment is now complete.

Flood repair work on track – updated information poster available

Progress to date – repairs on 249 sites have been completed. College Road stopbank realignment is now complete.

Check out the Flood Repair Poster for additional information and progress tracking to 30 June 2019.

Flood repair project poster
about 3 years ago

Launching access easier

Rock armouring repairs on a section of Rangitāiki River edge has proved an opportune time to create a long-awaited community asset.



Launching access easier

Rock armouring repairs on a section of Rangitāiki River edge has proved an opportune time to create a long-awaited community asset.

Talk of a launching area into the Rangitāiki River – particularly for waka ama – has been circulating for some years and a rotten-rock ramp has now been formed on the stopbank berm about 600 metres from Edgecumbe College. The proximity to the College was chosen to make it easier for students to actively engage in the sport of waka ama.

Flood Repair Project Manager Paula Chapman says the launching site is an area of flat rockwork stepped down off the berm and is suitable for small craft, including waka ama. “It made perfect sense to incorporate the ramp into the repair work Regional Council staff and contractors were carrying out at Olive Grove, one of the 224 sites damaged during the 2017 storm and flood event.”

As at 30 June 2019, repairs to 72 of the 224 damaged sites on the Rangitāiki-Tarawera River Scheme have been completed. Forty-nine of 53 sites within the Rangitāiki Drainage Scheme have been repaired. Overall forty-eight per cent of the 520 sites across the Council’s river and drainage networks damaged in the April 2017 storm event have been completed.

Rangitaiki River edge
about 3 years ago

Flood repair work on track – updated information poster available

Work on 59 sites has been completed over the summer months. All sites in the Waiōtahe river scheme are now complete.

Flood repair work on track – updated information poster available

Work on 59 sites has been completed over the summer months. All sites in the Waiōtahe river scheme are now complete.

Check out the Flood Repair Poster for additional information and progress tracking to 31 March 2019.

about 3 years ago

Work is underway on a flood-damaged section of Lowe Road near Waimana, as part of a joint Bay of Plenty Regional Council and Whakatāne District Council project to provide safer road access for local residents.

Work underway on flood-damaged section of Lowes Road

Joint BOPRC and WDC Media release

Work is underway on a flood-damaged section of Lowe Road near Waimana, as part of a joint Bay of Plenty Regional Council and Whakatāne District Council project to provide safer road access for local residents.

Bay of Plenty Regional Council Flood Recovery Project Manager Paula Chapman said the section had been badly eroded in the April 2017 flood event and scoured away to such an extent that the road surface itself was impacted.

“The Tauranga River runs alongside Lowe Road in several places and during the April 2017 flood event, it eroded the banks, putting the road at risk in several places. This is one of our high priority repair sites and part of the $11.47m budget we have set aside for the 2018/19 year,” Ms Chapman said.

Whakatāne District Council Transportation Manager Martin Taylor said the rural road was an important link between Waimana and communities up the Matahī Valley and was used daily by the school bus and local traffic.

“Since the April 2017 flood, sections of the road have had to be narrowed with cones and orange mesh fences where the road shoulder has been completely eroded away. The next flood could easily be the one that then takes the road itself away. To ensure that doesn’t happen we are working together with the Regional Council to reinstate the road shoulder and strengthen the river bank.

“We expect works to continue for the coming six weeks and hope to fully reopen the road by the end of April,” Mr Taylor said.

Contractors will realign the river channel to provide a working area for repairs. There will then be significant work to bench the river bank up to road level, before the road is repaired and resealed.

“Benching and stabilising the riverbank back up to road level will require a lot of rock material and we have been stockpiling that on-site for some weeks now, so our thanks go to local users who are being inconvenienced by additional truck movements. Please continue to take care around the work-site for the coming months,” Ms Chapman said.

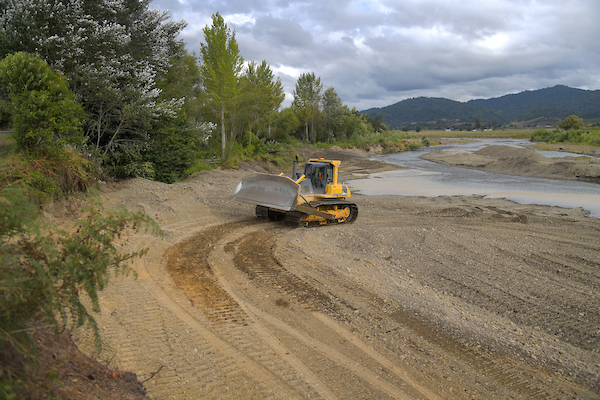

Waimana works
about 4 years ago

Stockpiling rocks in anticipation of busy repairs

In 2017-2018 we completed repairs to 119 of the 520 sites along our rivers and drains that were damaged during the April 2017 flood events.

Stockpiling rocks in anticipation of busy repairs

In 2017-2018 we completed repairs to 119 of the 520 sites along our rivers and drains that were damaged during the April 2017 flood events. Over the next twelve months we will be working to complete repairs to a further 145 sites across the region.

Much of the repair work involves rock, lots of rock. So over winter rock has been carted to stockpiles near the repair sites in preparation for settled weather, drier ground conditions, and the start of the construction season.

To give you an idea of rock volumes - site RT116 on the Rangitāiki River will need about 4000 tonne of graded rock - that's 182 truck and trailer loads! And this is just one of many flood repair jobs of this scale.

Check out the Flood Repair Project poster for more information about the project and what’s happening in 2018-2019.

Stockpile of rocks ready for flood repairs.
about 4 years ago

College Road flood repair work – focus now moves to road construction

Removal of the temporary stopbank and reinstatement of the berm has been completed with river edge rock strengthening continuing until the middle of the month.



College Road flood repair work – focus now moves to road construction

Removal of the temporary stopbank and reinstatement of the berm has been completed with river edge rock strengthening continuing until the middle of the month.

Contractors have now moved their resources onto road construction and (weather permitting) the aim is to be installing the kerb and channel in the coming week. An alternative pedestrian detour is in place to keep people safe during the final phase of the road construction.

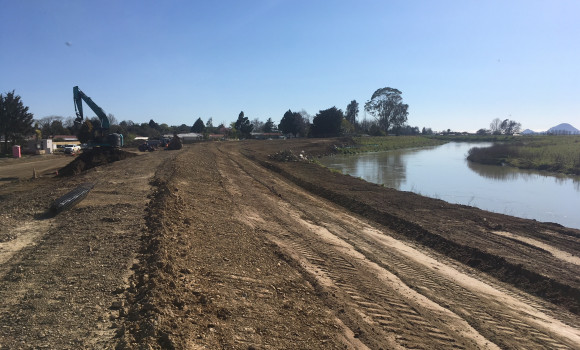

College Rd flood repairs.
about 4 years ago

College Road stopbank completion marks major milestone in flood-repair project

The completion last week of the new section of the College Road stopbank in Edgecumbe marks a major milestone in the Bay of Plenty Regional Council’s April 2017 Flood Repair Project.

College Road stopbank completion marks major milestone in flood-repair project

The completion last week of the new section of the College Road stopbank in Edgecumbe marks a major milestone in the Bay of Plenty Regional Council’s April 2017 Flood Repair Project.

Engineering Team Leader Peter Hay says contractors are now working on the removal of the existing temporary stopbank, and reinstatement of the berm, a process which will take a further two weeks of good weather.

“When that final stage is complete, the town’s flood defence will be at the full design standard agreed in Council’s Rivers and Drainage Asset Management Plan. The relocation of services such as communications cabling and storm water systems and the construction of the new road have been happening in parallel with the stopbank work. Services are now complete and the foundation of the road is in place and our aim, again weather permitting, is to have the road completed in mid-September,” Mr Hay says.

College Rd stopbank works.
about 4 years ago

Great turnout at Rangitaiki Information Day

Thanks to everyone who came along to find out more about Council's various projects in the lower Rangitaiki on Saturday.

Great turnout at Rangitaiki Information Day

Thanks to everyone who came along to find out more about Council's various projects in the lower Rangitaiki on Saturday.

Around 40 people attended and there was great discussion and positive feedback. Remember you can keep up-to-date with progress and activities by registering to follow the April 2017 Flood Repair Project.

Rangitāiki info day
